History

The Champlain Bridge deconstruction is the largest project in JCCBI’s history and is a unique project for Quebec. Its overall $400M envelope includes:

  • Deconstruction work at a cost of $225.7M
  • Environmental protection measures
  • Material reuse and Research & Development programs

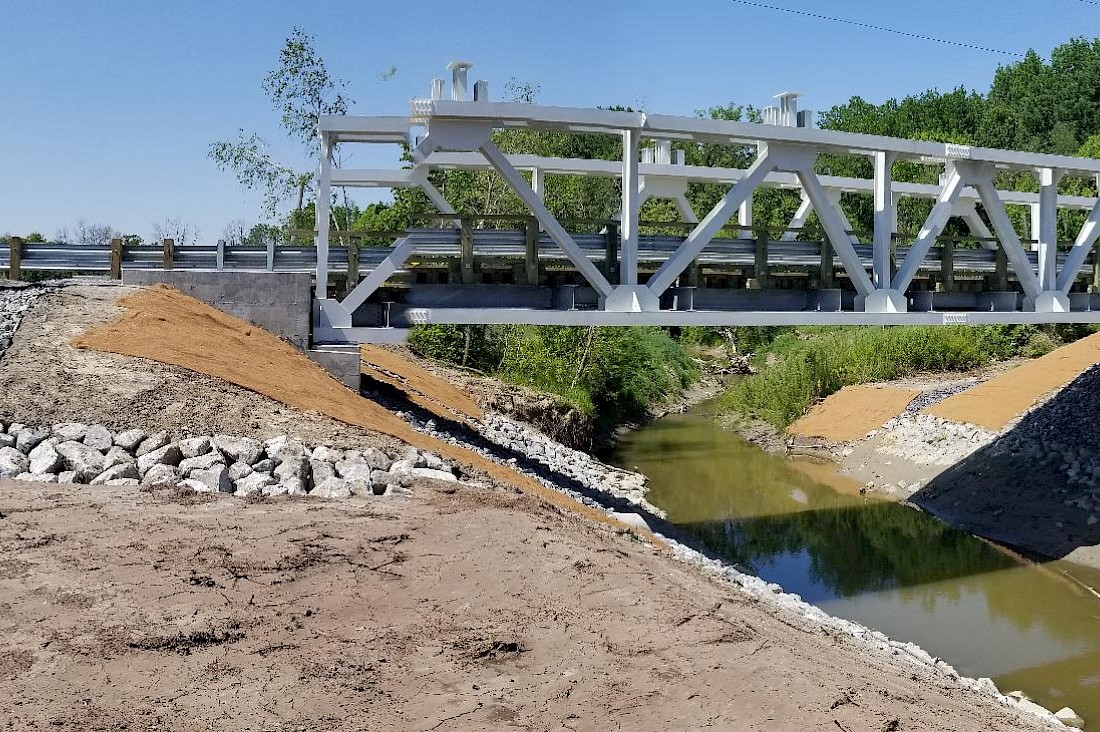

  • Redevelopment of the shoreline at the end of the project

The deconstruction work is being carried out by the Nouvel Horizon Saint-Laurent (NHSL) consortium formed by Pomerleau Inc. and Delsan A.I.M Environmental Services Inc.

Main project stages

2023
May

First public meeting to present the three redevelopment concepts of the Héritage Champlain project.

April

Material reuse competition from the original Champlain Bridge: JCCBI unveils 11 projects selected.

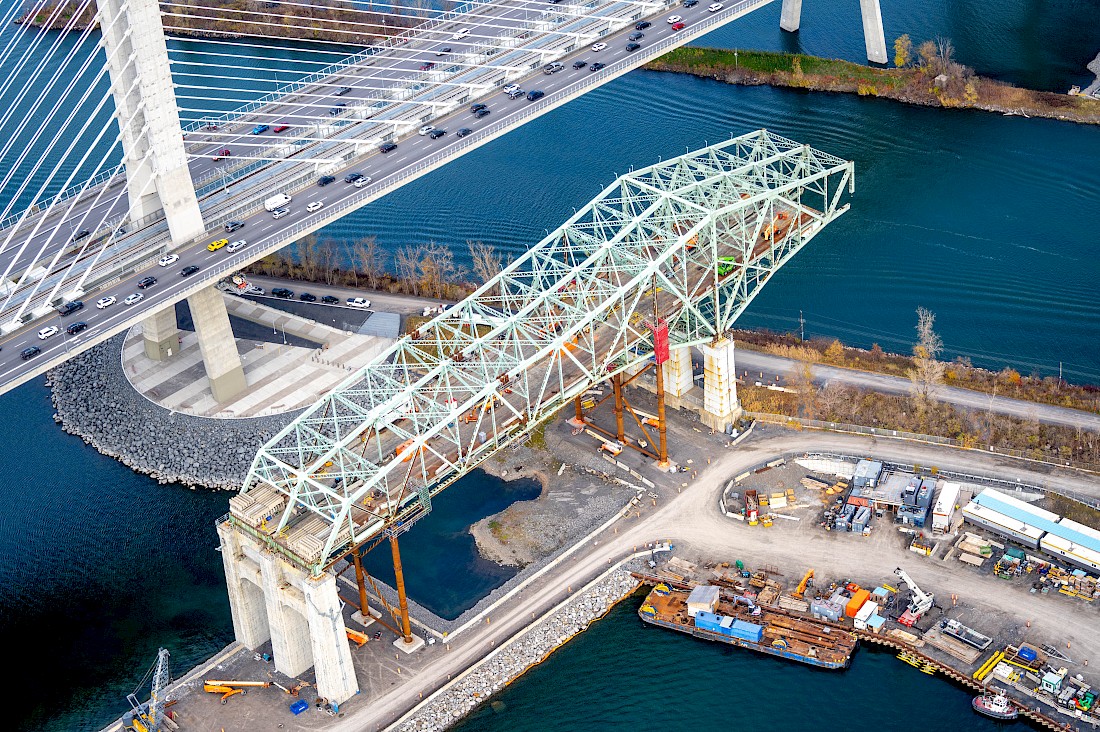

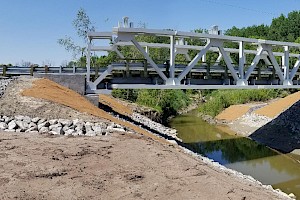

Deconstruction of the last cantilever section of the west span located over the St. Lawrence Seaway dike.

3rd research and development forum on the Champlain Bridge deconstruction organized by JCCBI and conducted in partnership with Canadian research bodies.

2022
From November 4 to 7
May 13

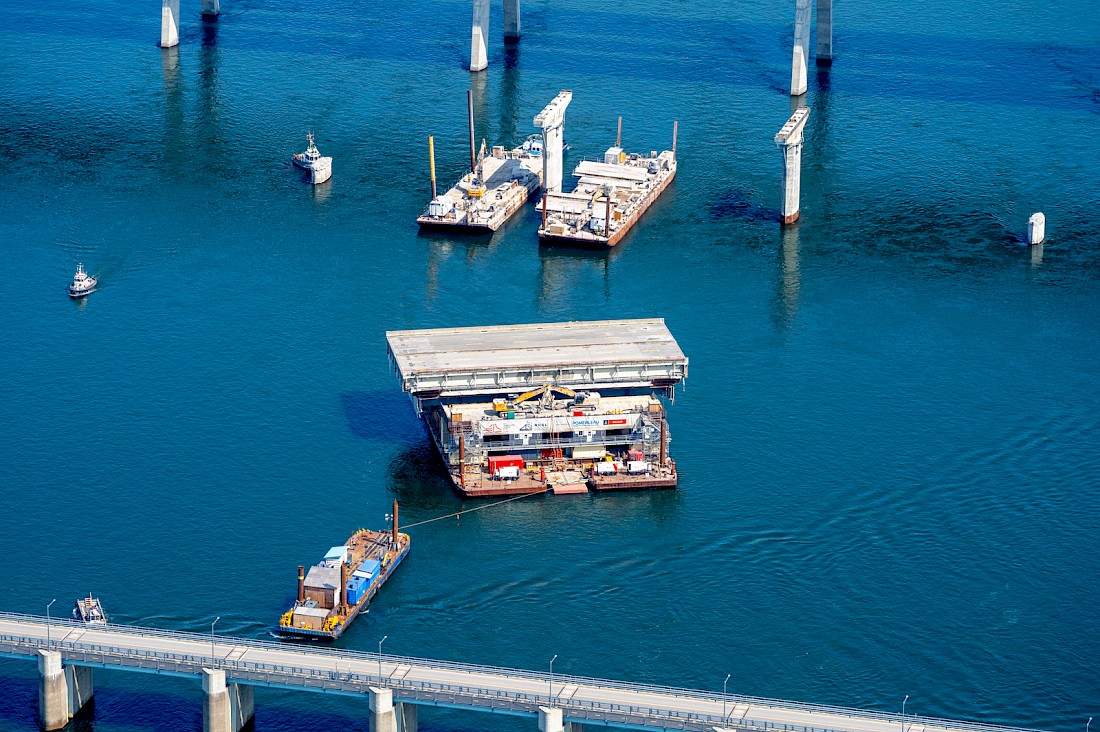

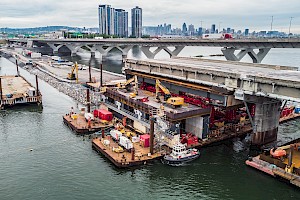

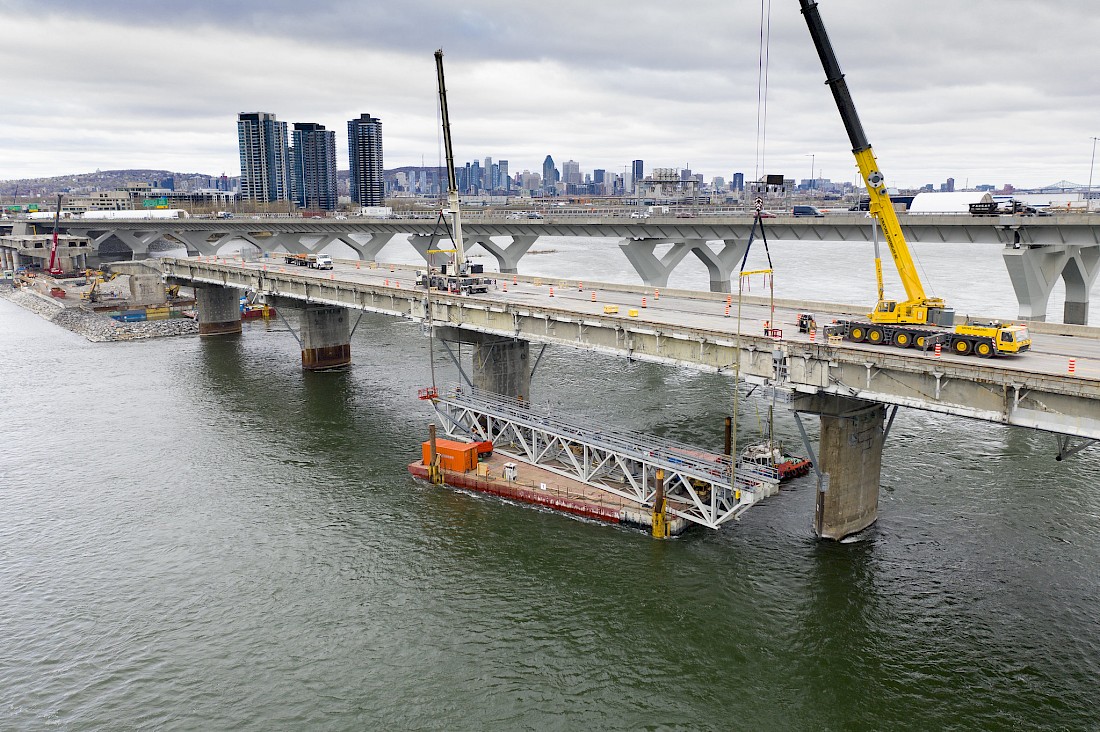

Removal of the 30th marine span between Île des Soeurs and the St. Lawrence Seaway dike.

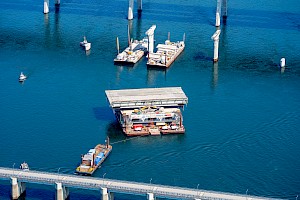

End of the use of the catamaran barge,also called the “River Giant,” which helped our crews lift and deconstruct the spans in the marine sector while protecting the St. Lawrence River.

Highlights

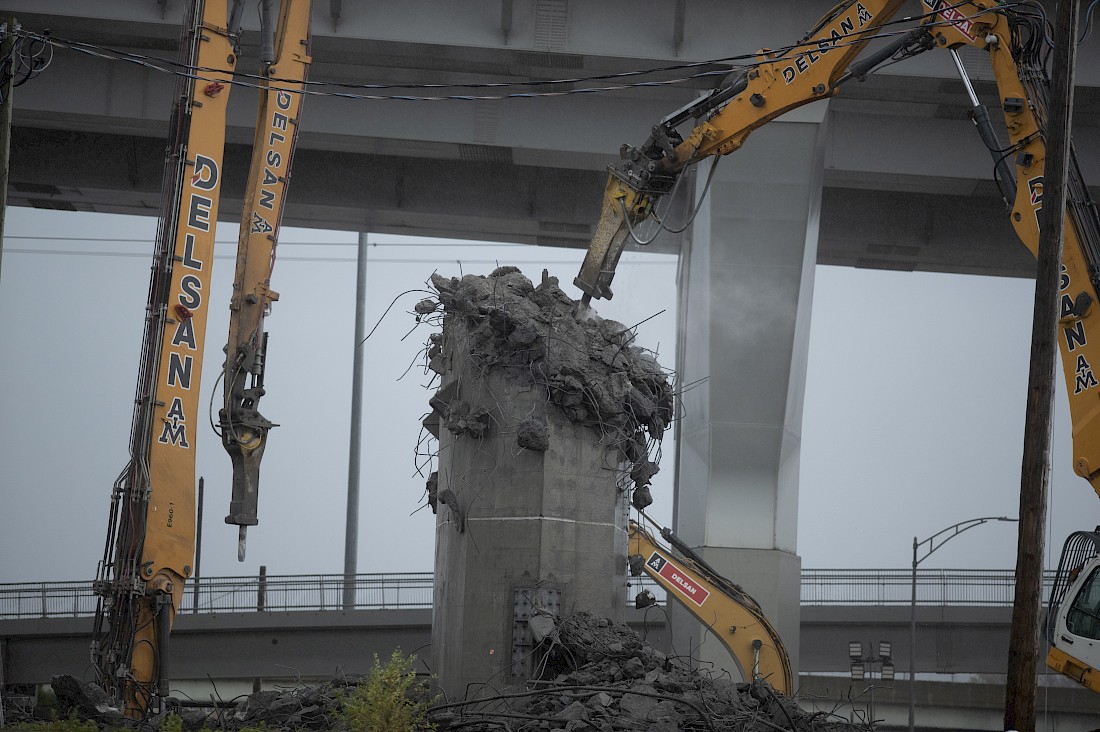

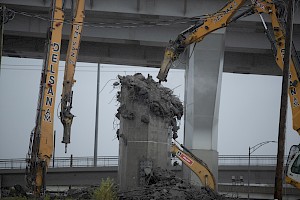

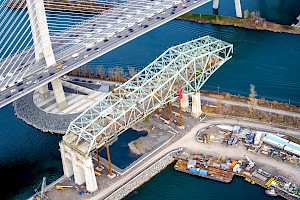

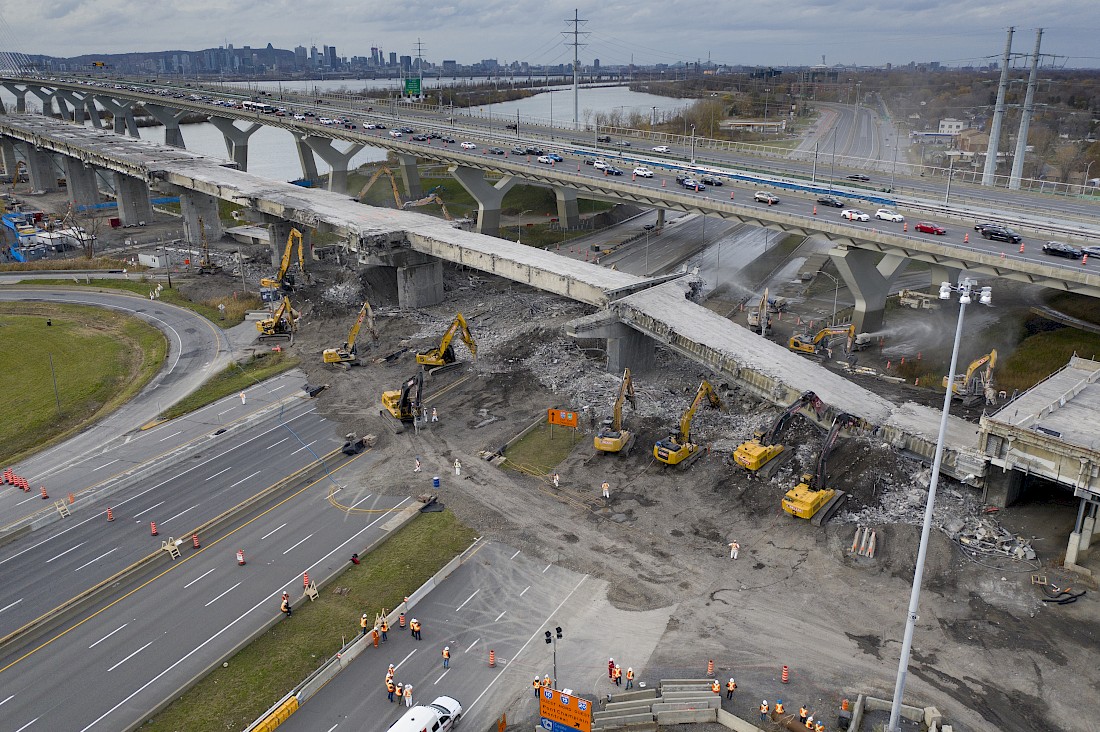

  • Removal of 43 piers and 42 footings between Île des Soeurs and the St. Lawrence Seaway dike.
  • End of the dismantling of the main span at Léon-Gravel Park in Brossard.
  • End of the dismantling of the east span of the cantilever (on the Brossard side).

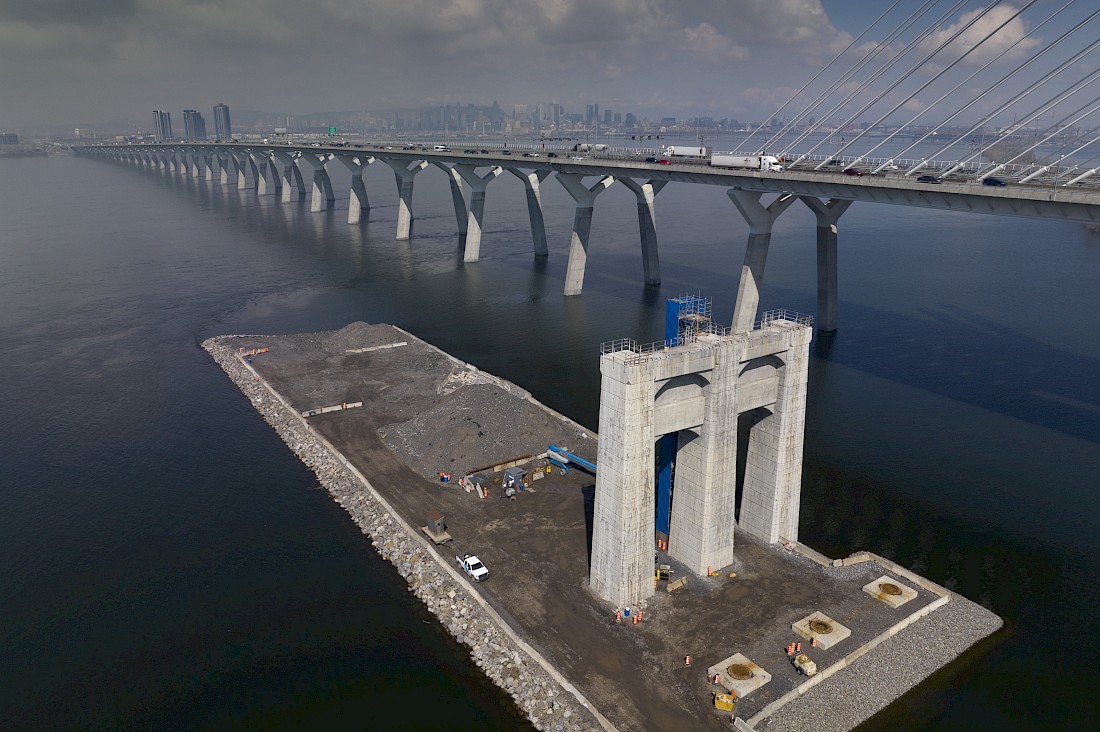

  • Installing two temporary tower systems supported on the jetty in the Lower La Prairie Basin in Brossard

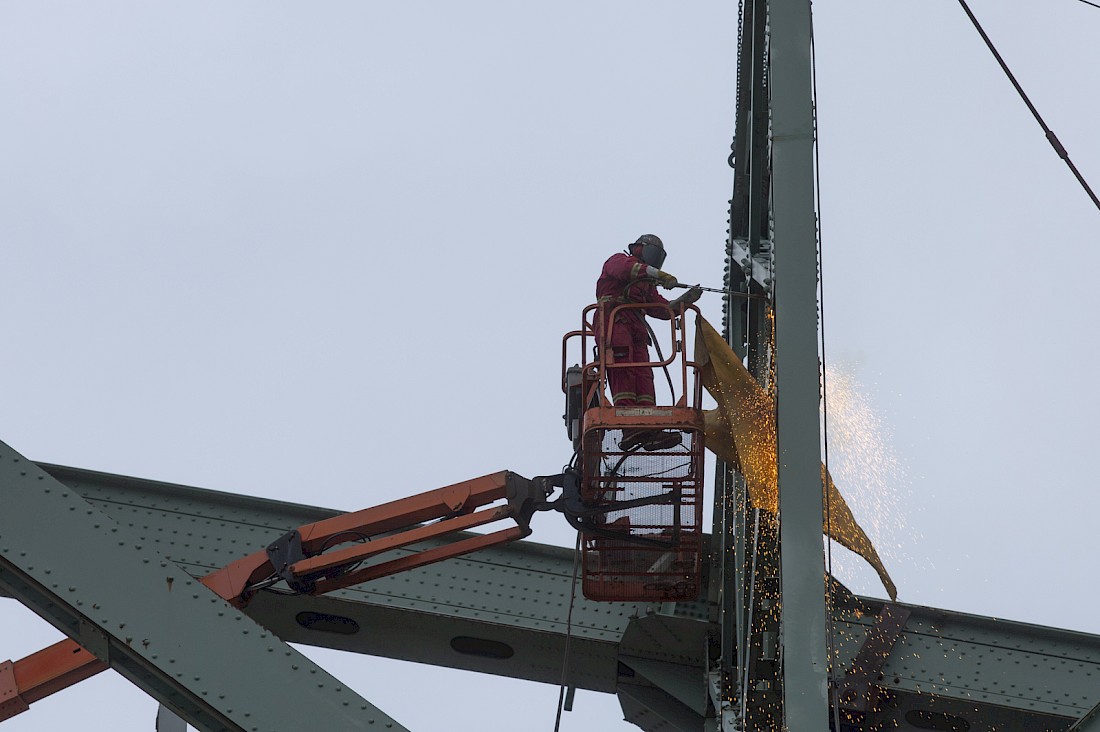

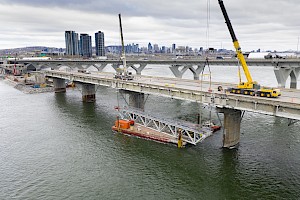

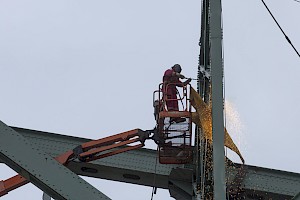

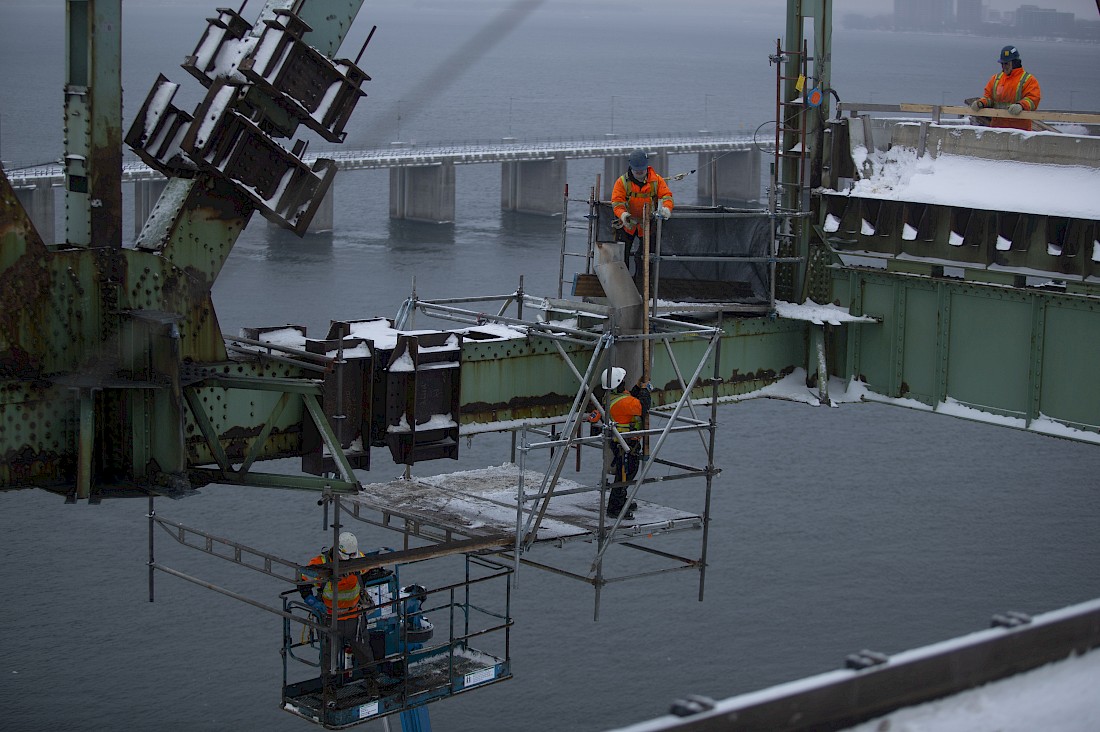

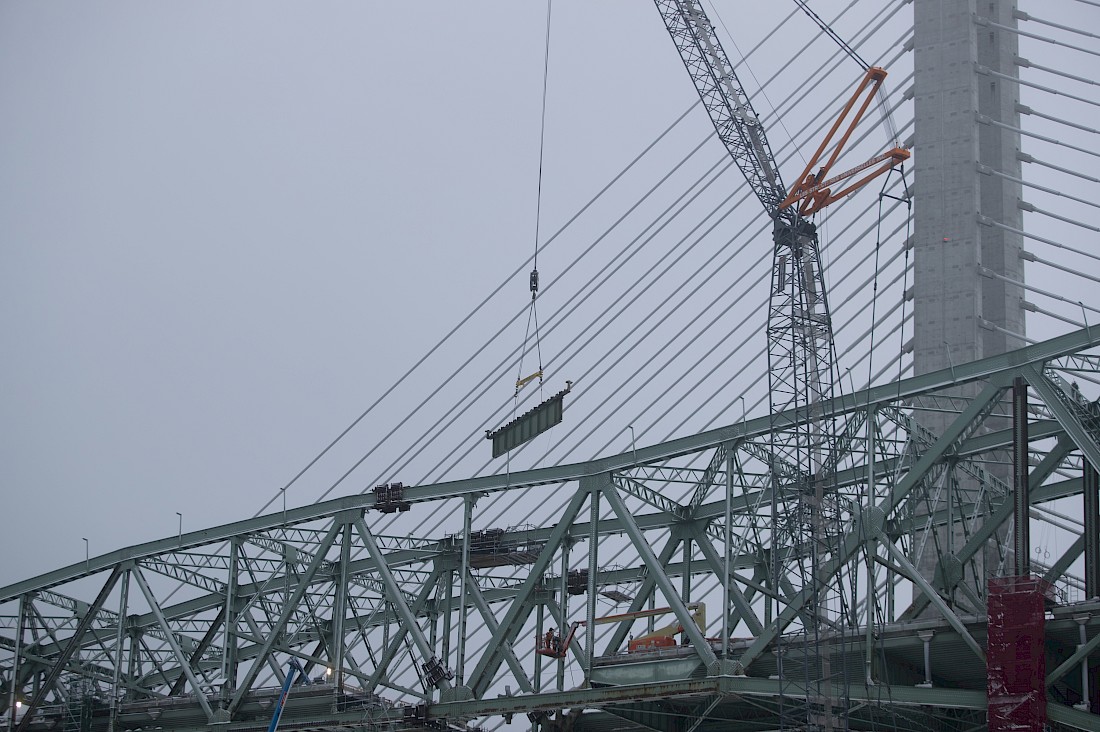

  • Installing steel reinforcements on the existing structure
January 8

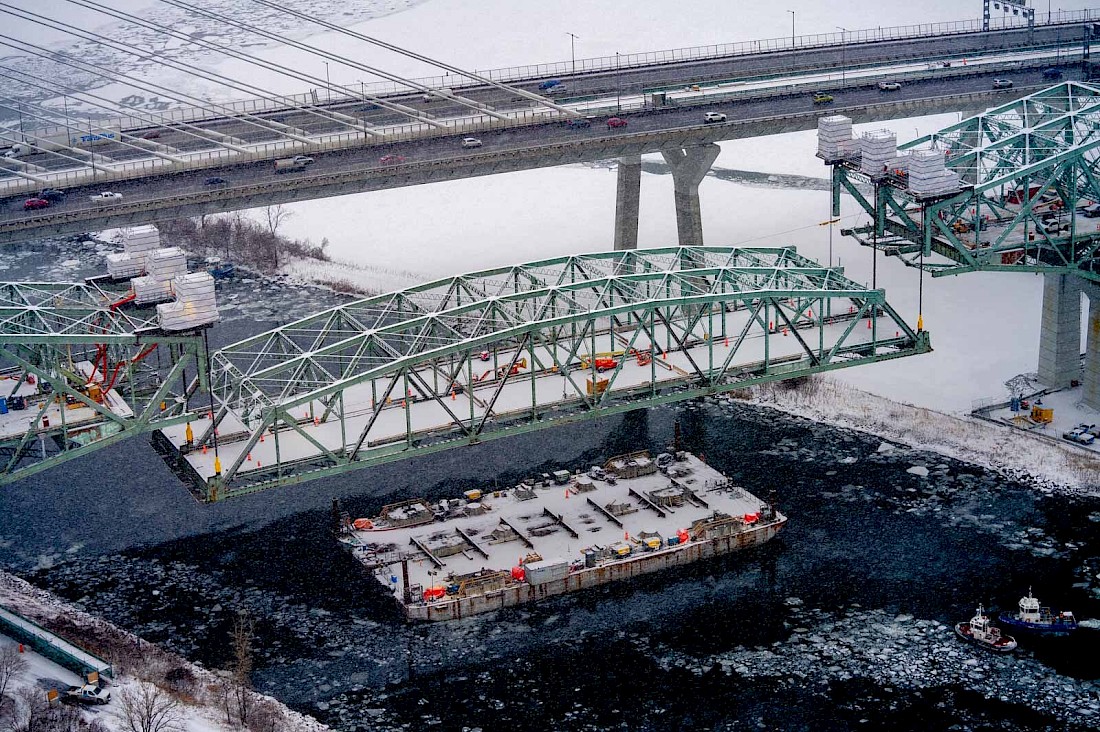

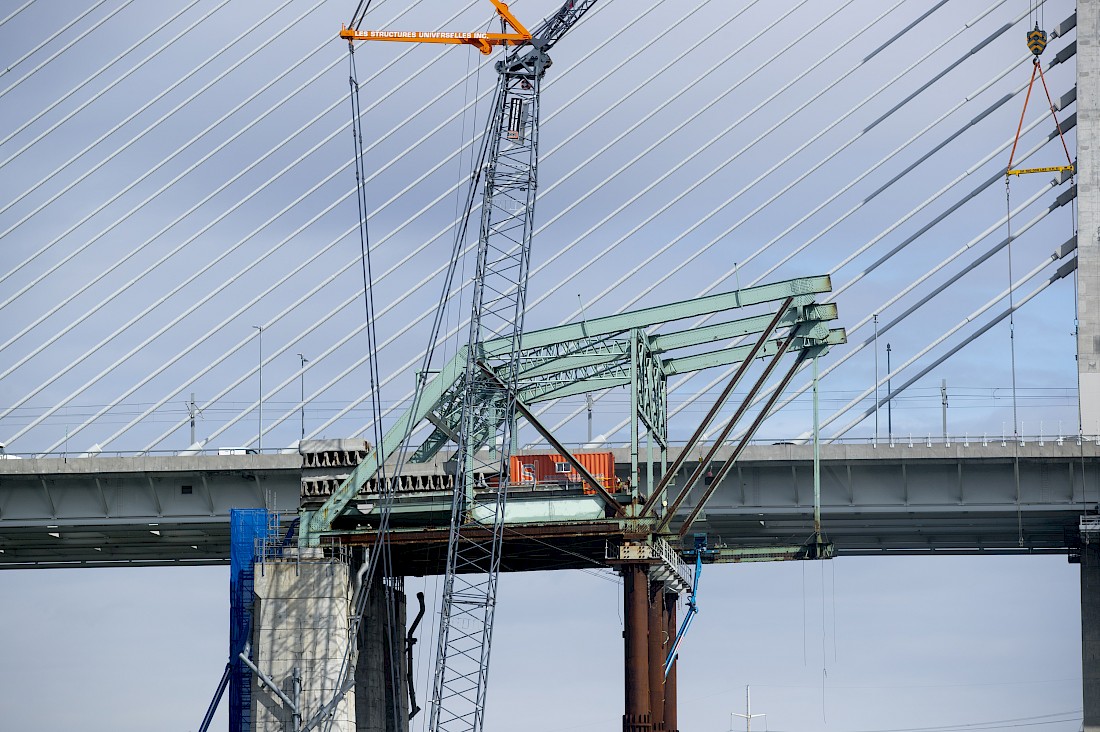

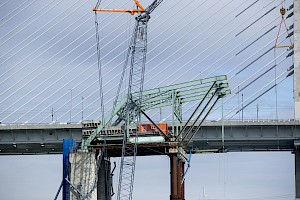

Transport of the span to the dismantling site in Brossard

January 7

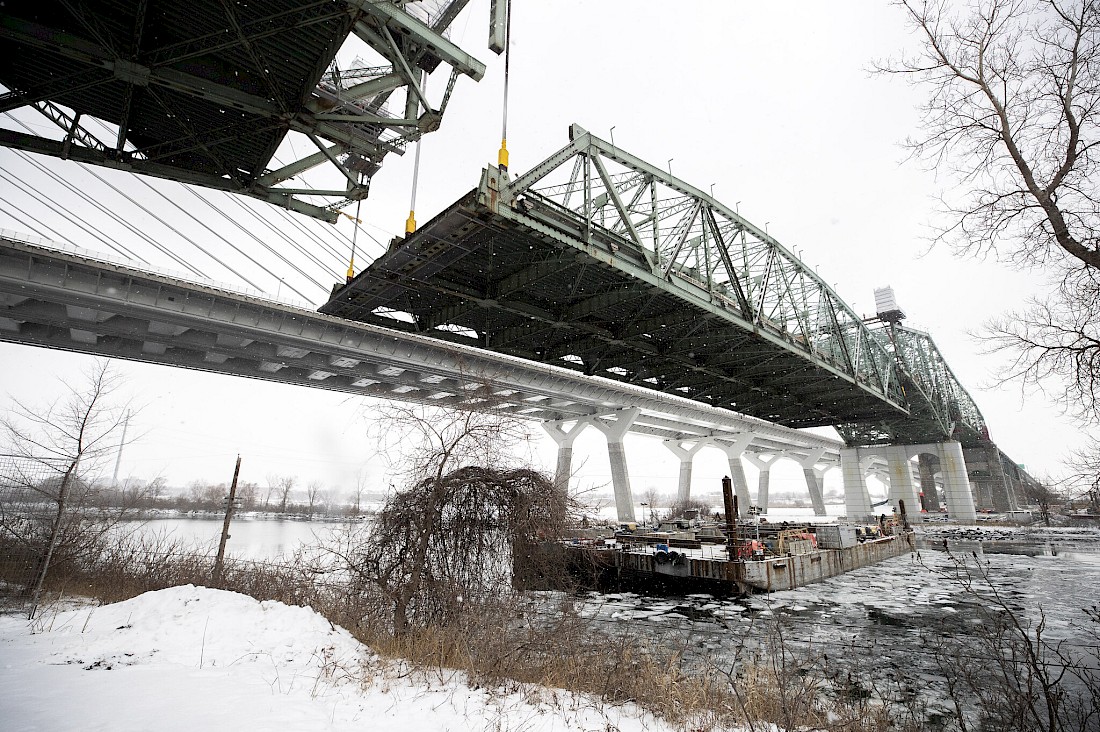

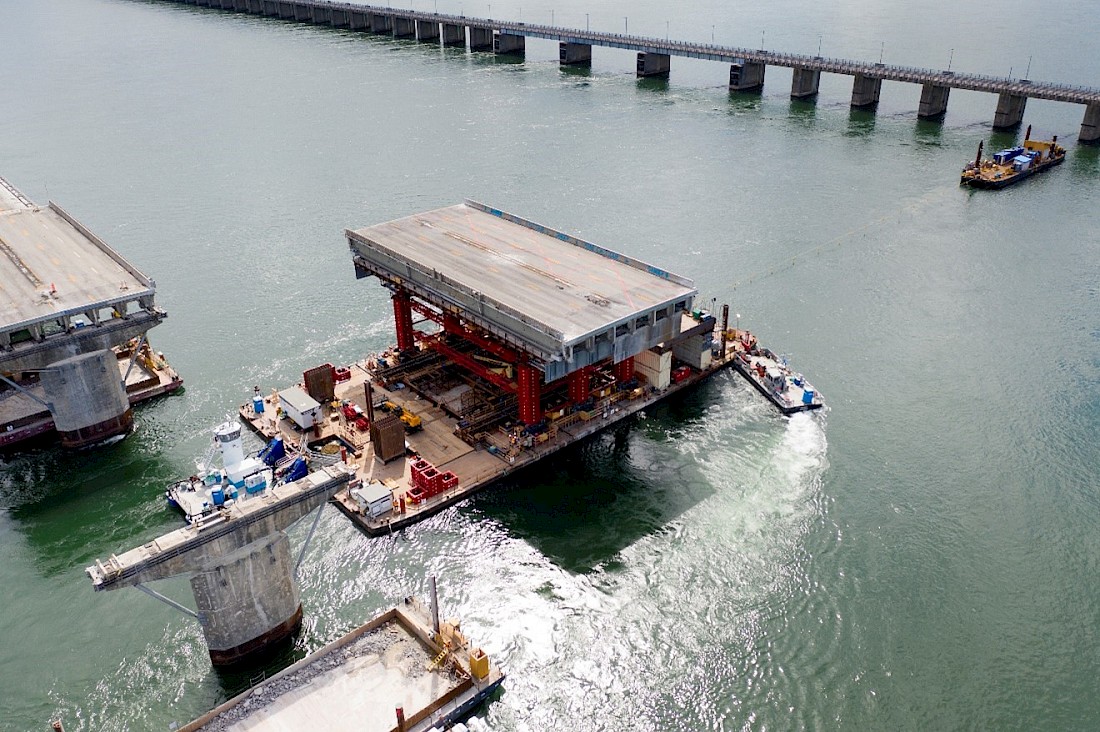

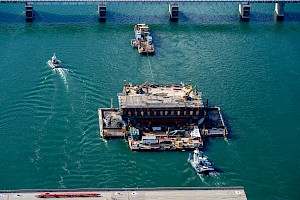

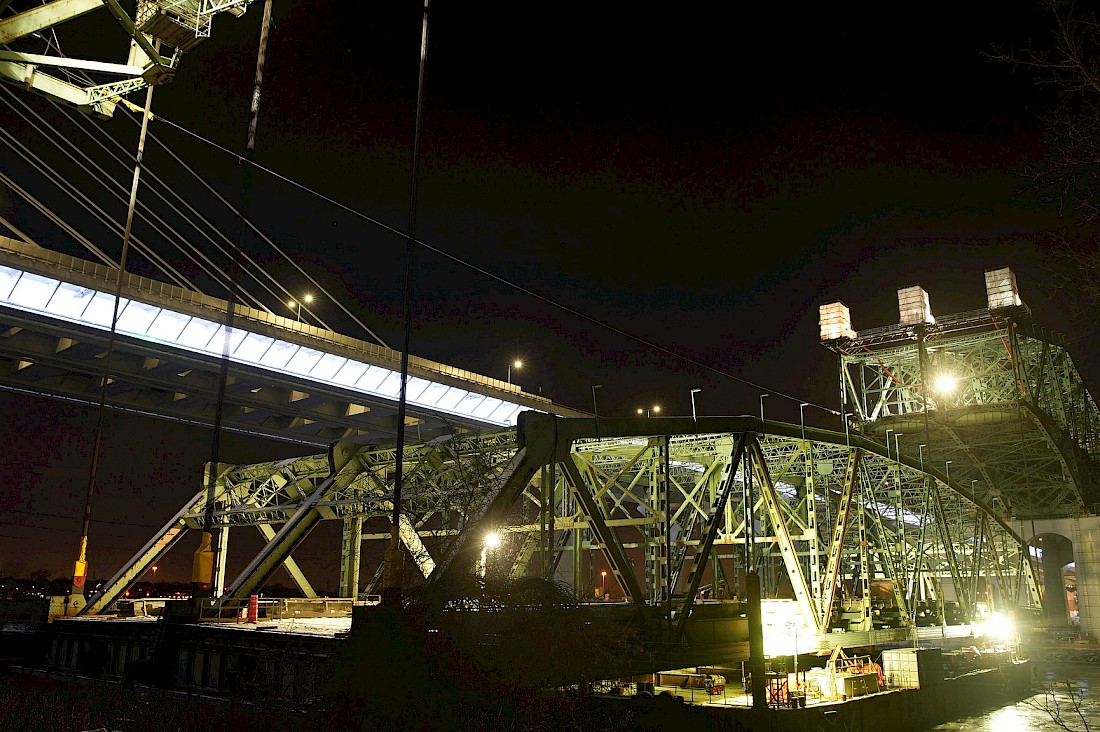

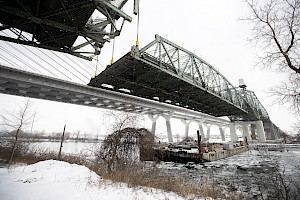

Lowering of the suspended span over the St. Lawrence Seaway

January 6

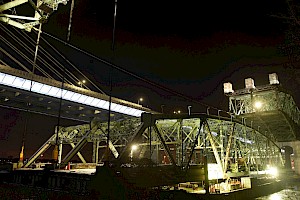

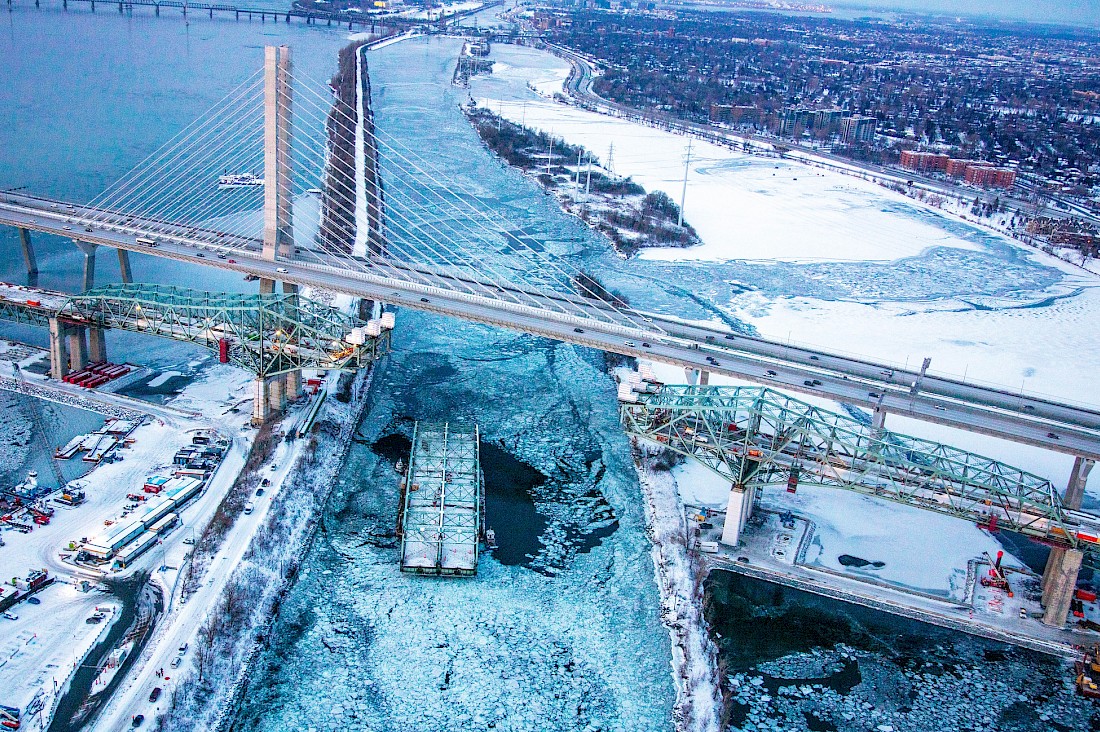

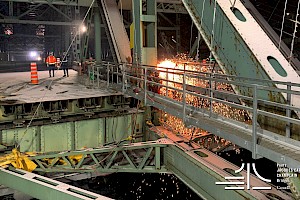

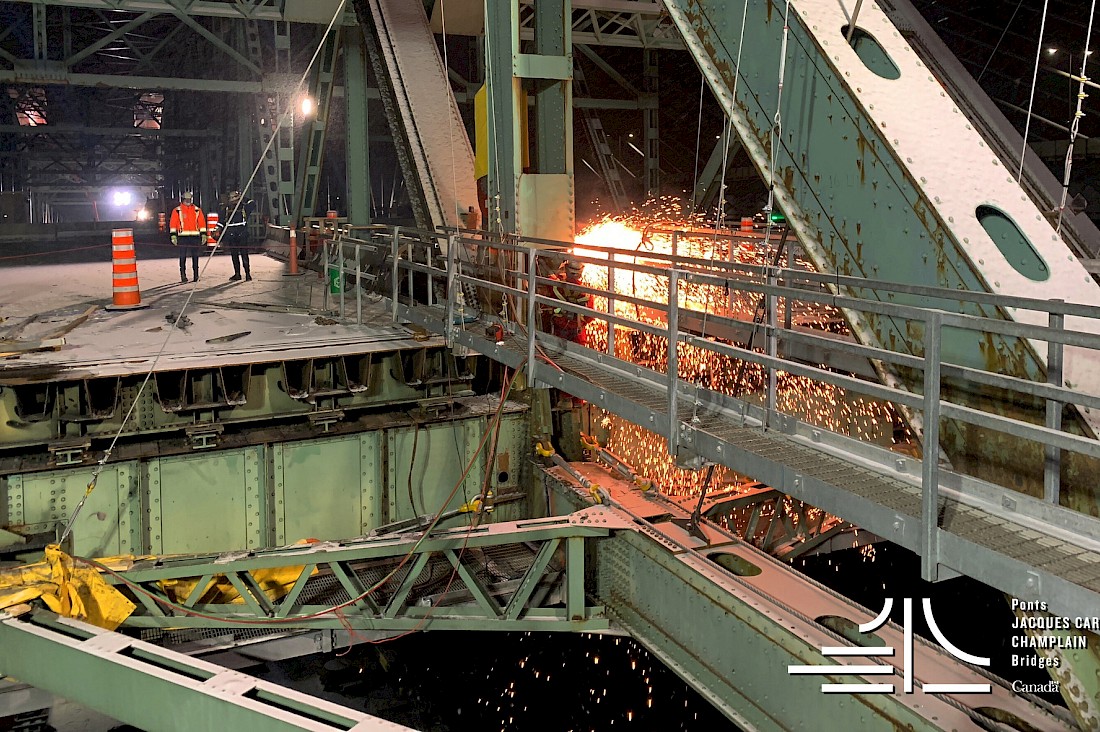

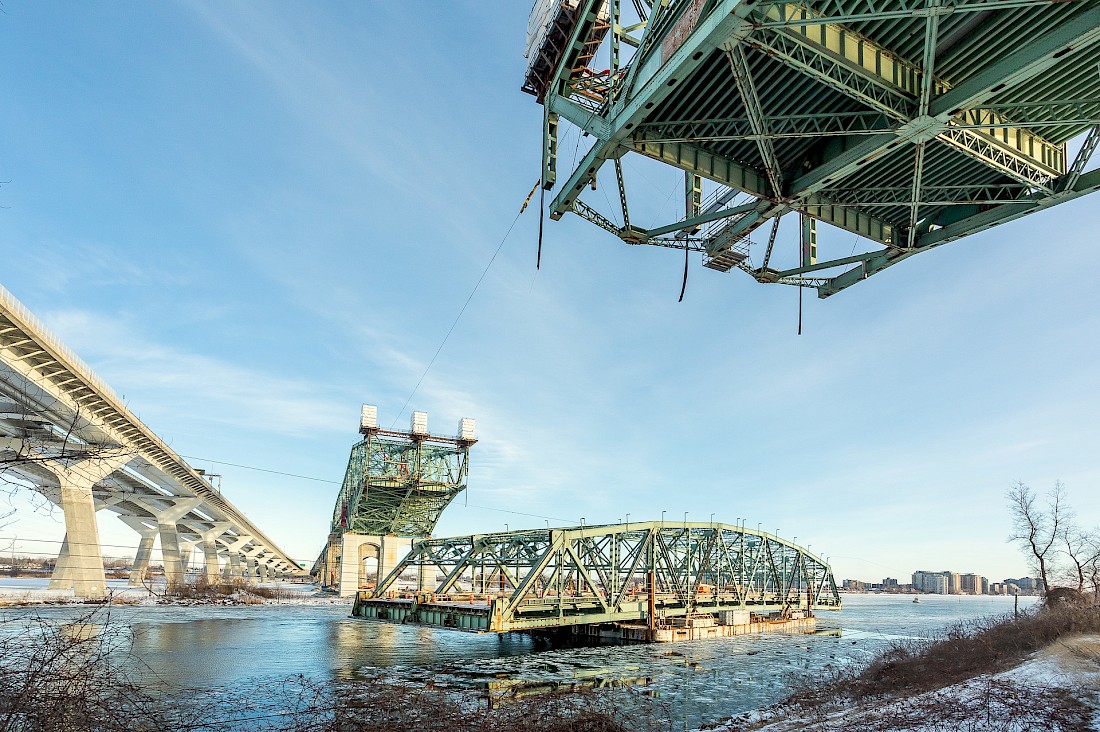

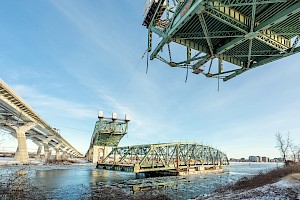

Separation of the suspended span over the St. Lawrence Seaway

2021
December 31

Deadline for submitting projects for the Material Reuse Competition

December 6

Third virtual meeting with the residents of Île des Soeurs and Brossard

June 2

Second virtual meeting with the residents of Île des Soeurs and Brossard

June 1
Highlights

Work on Île des Sœurs and the jetty: complete deconstruction of piers, spans and abutment

Marine work:

Preparatory work to take down suspended span over the seaway

Construction of temporary jetty built along the seaway dike

Construction of the temporary jetty in Brossard (phase 2)

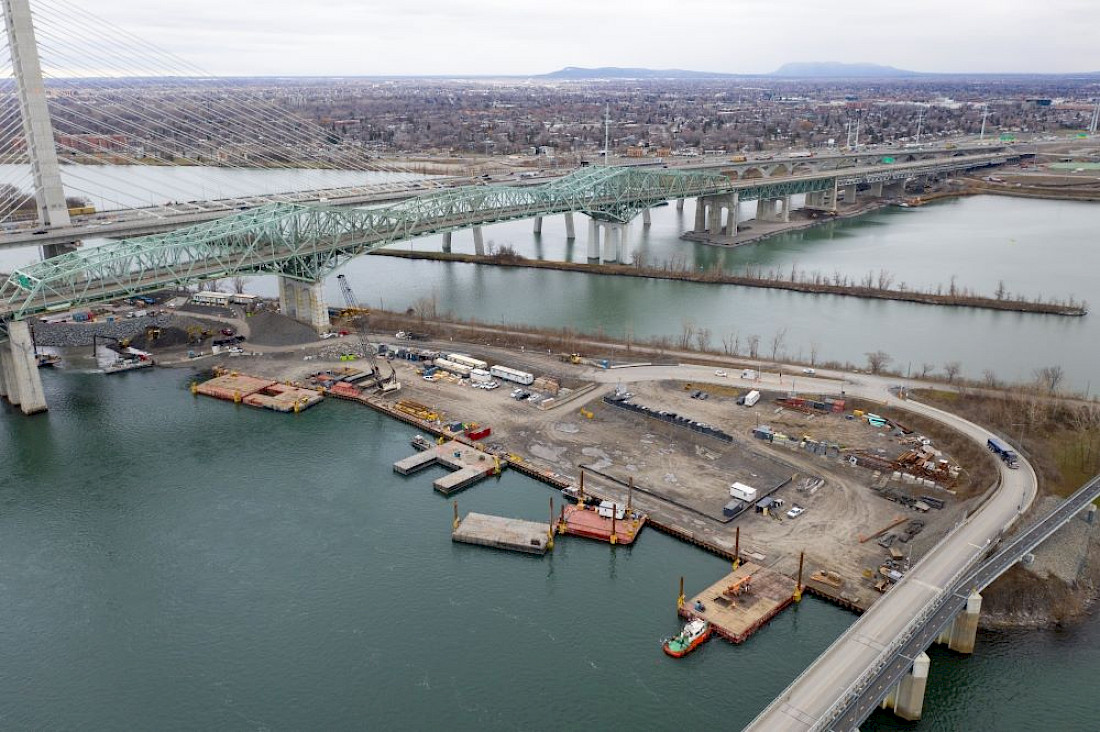

2020
October 29

First virtual meeting with the residents of Brossard

October 20

First virtual meeting with the residents of Île des Soeurs

October 13
June 26

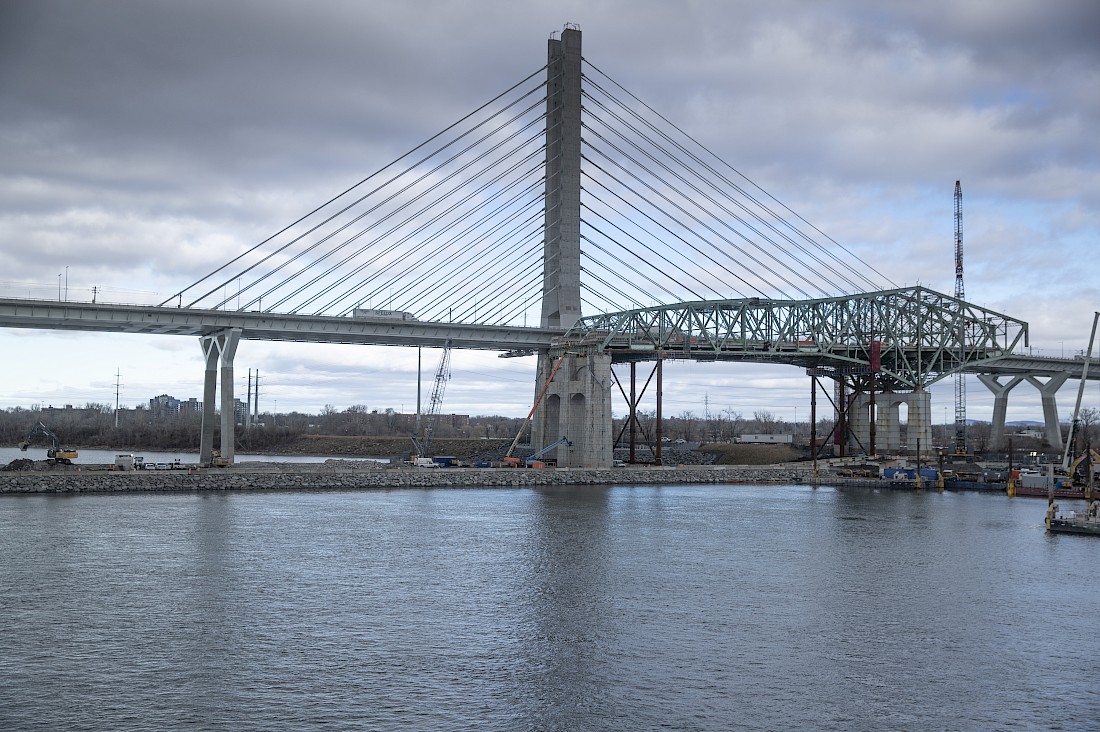

Design-build contract awarded to NHSL for the deconstruction work

March 5

NHSL chosen as the successful tenderer for the deconstruction work

Highlights

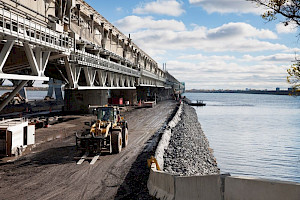

Start of work on Île des Sœurs:

Construction of temporary jetties on Île des Soeurs and in Brossard (phase 1)

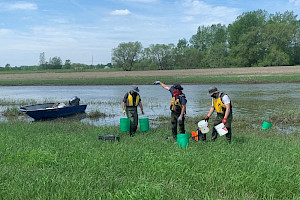

Start of the fish habitat compensation project in Saint-Ignace-de-Loyola in partnership with the Nature Conservancy of Canada (NCC)

2019
Fall

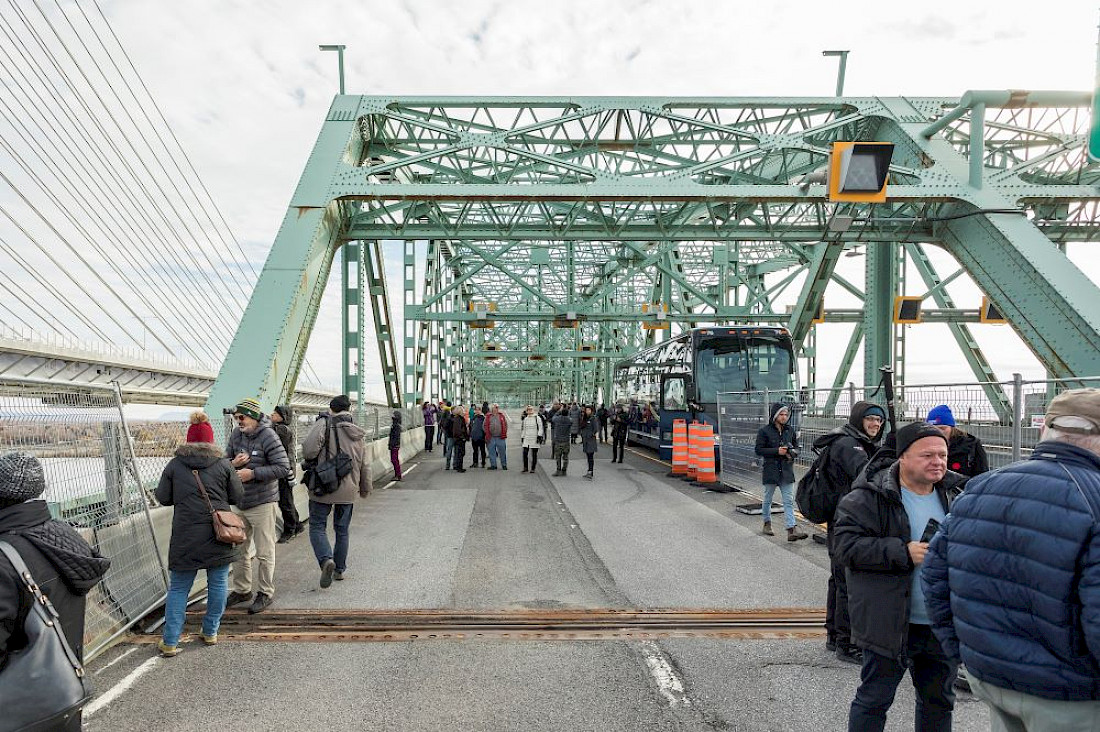

Guided tours of the Champlain Bridge in partnership with Héritage Montréal

Publication of the Targeted Environmental Analysis (TEA)

Summer

Commissioning of the new Samuel De Champlain Bridge, which opened partially toward Montreal on June 24, 2019 and then in both directions on July 1, 2019.

Decommissioning of the original Champlain Bridge

Spring

Start of public meetings
